Strategic plan update
MFC Sports Pavilion
After many years of hard work we are getting closer finishing our club rooms that form part of the Melrose FC Sports Pavilion (Stage 9 of the strategic plan).
You can check out the Sports Pavilion page to learn more, and even view some amazing concept renders.
10 May 2024
Blockwork and service installation continues. Roof work is next.

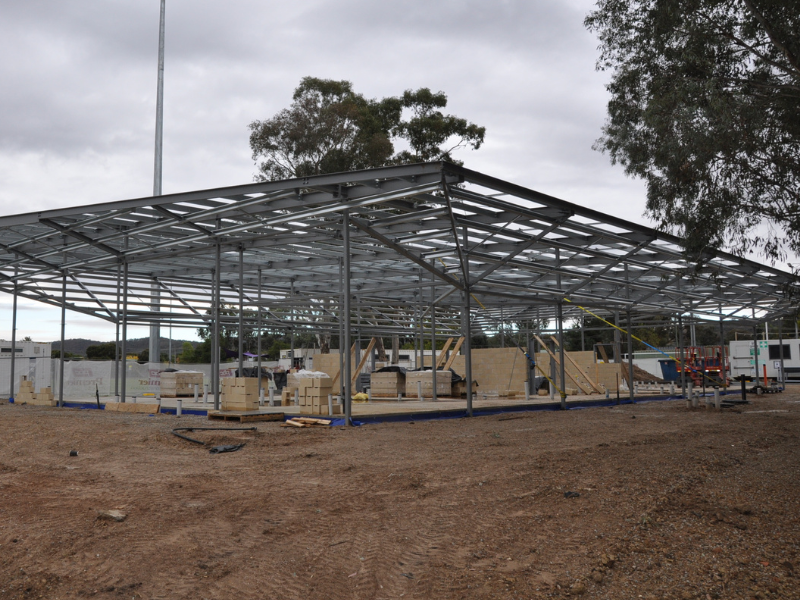

3 May 2024
Storage and changeroom access.

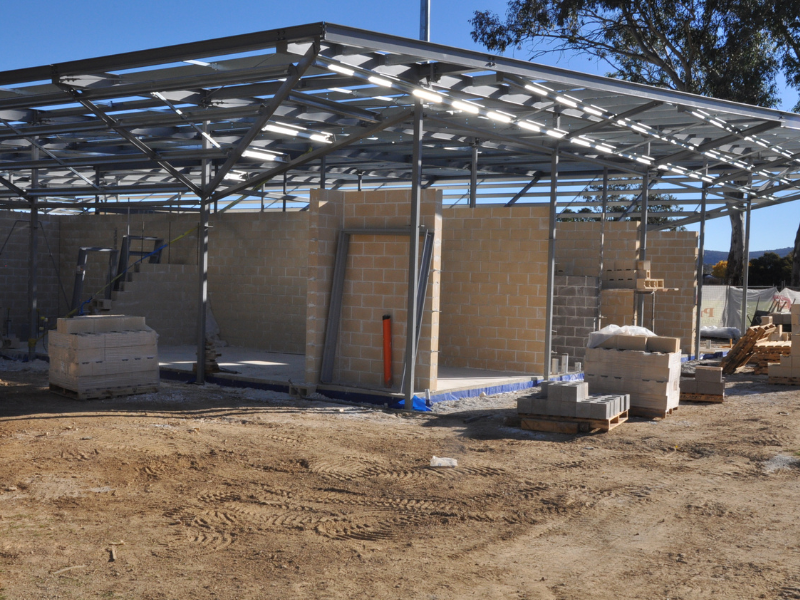

19 April 2024
Internal blockwork continues.
29 March 2024
The steel framework has arrived on site. Installation has commenced.
1 March 2024
Foundations.
16 February 2024
Excavation and formwork underway for the raft slab.
1 December 2023
At the Council meeting held on 27 November 2023, Council accepted the tender from Premier Building Construction Pty Ltd (PBC) for the construction of the Melrose Park Sports Pavilion. Construction is scheduled to commence in early 2024.
18 August 2023
After a lengthy detailed design process, the construction tender was uploaded to Tenderlink today. Tenders close 12 September 2023. Following assessment, a report will be presented to Council recommending a preferred contractor.
1 April 2022
There has been delays in progressing the detailed design of the building however procurement processes are well underway now and scheduled to close on 22 April 2022. Following the engagement of the design consultant, a review of timelines for detailed design completion, construction Tender awarded, construction commencement and project completion will be undertaken.
18 February 2022
Detailed design process is underway with construction ender due to be advertised in coming months.
29 October 2021
The Review of environmental factors has been determined. Work can now commence on detailed design
1 October 2021
The concept designs have been finalized with public exhibition process closed. The review of environmental factors is complete and awaiting determination.
